How To Compare Commercial Builder Quotes Beyond Price
The lowest commercial builder quote can become the most expensive proposal once any omitted work, weak allowances and untested sequencing are added back in.
First, make the scope and assumptions equivalent. Then compare the normalised price with the builder's plan for delivering the work.
Why the lowest quote is not always the lowest project cost
A quote is only cheap if it includes the work. But things like authority fees, temporary services, protection, testing, commissioning and make-good costs do not disappear when they are omitted. They become client costs, variations or delays later on.
The cheapest builder may still be the most efficient. Just ask where the saving comes from.
Better supplier pricing, simpler sequencing or lower overheads can all produce a genuine advantage, and remember that a saving that depends on reduced scope, a different finish or easier site access is not the same offer.
Establish a comparable scope before reviewing prices
If two tenderers have priced different jobs, their totals tell you very little. So what you need to do is put every return against the same drawings, specification and scope before ranking it.
- List every qualification and omission in one comparison register.
- Add an adjustment for work priced by one builder but not another.
- Separate genuine alternatives from departures in scope.
- Issue material clarifications to every tenderer through the agreed process.
For example, one proposal may include hoarding changes, after-hours access and temporary egress while another assumes unrestricted daytime work.
Those prices cannot be compared until the site conditions match.
That is why Coverite's commercial project process resolves scope, constraints and staging before construction starts.
Read inclusions, exclusions, allowances and assumptions together
Inclusions, exclusions, allowances and assumptions work as a set. Read one in isolation and it is easy to miss where a cost or responsibility has moved.
A provisional allowance may look sufficient until an assumption limits it to standard finishes, normal working hours or an incomplete services design. An exclusion may leave the client to appoint a consultant, purchase an item directly or coordinate work outside the contract.
Ask for the basis of each material allowance. Replace it with a fixed price where the scope is developed enough. If that is not possible, record who carries the difference and how it will be assessed.
Test the programme and procurement logic behind the price
A completion date is not a construction schedule.
The tender should show how the builder intends to reach it, including:
- Design decisions and approvals needed before procurement.
- Long-lead items and their release dates.
- Staging, shutdowns and access restrictions.
- Testing, commissioning and handover.
On an occupied site, challenge any timeline that relies on unrestricted access or instant client decisions. Ask what sits on the critical path and what happens if a key approval or delivery date slips.
Compare coordination, methodology and live-site capability
A methodology exposes assumptions that the price may not.
It should cover the proposed team, consultant interfaces, site logistics, subcontractor coordination and communication with people using the building.
Take a staged school refurbishment for example:
The demolition and finishes may be identical across two quotes, but holiday shutdowns, hoarding moves, acoustic controls and progressive room handovers still need labour and time. A tender that ignores them has not priced the same delivery problem.
For jobs like this, it’s best to look for relevant occupied-site experience and confirm that the proposed people were involved in those projects.
Coverite's commercial building delivery work shows how staging and operational continuity are handled in practice.
Assess variation, governance and reporting risk
Small changes become harder to control when approval rules are vague. Before appointment, agree who can instruct a change, when pricing is required and what can proceed without written approval.
The reporting format should show the current contract value, approved and pending variations, schedule movement, open design decisions, quality issues and handover status.
Coverite's construction project management approach keeps those decisions and records connected to the work on site.

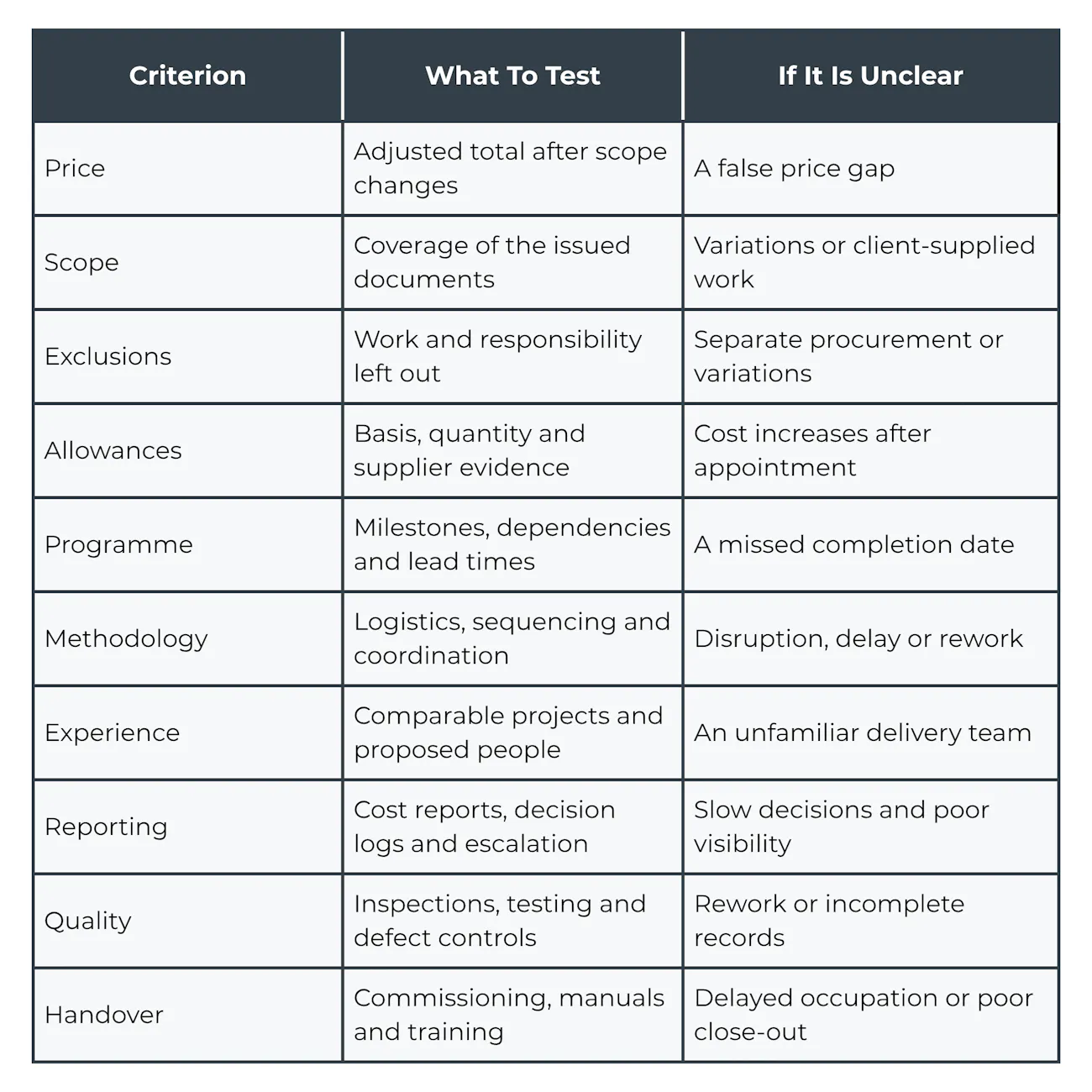

Use a weighted commercial builder comparison
The Australian Government Department of Finance says price is not the sole factor when assessing value for money. Its guidance also lists quality, fitness for purpose, relevant experience and whole-of-life cost.
Those rules do not automatically apply to private projects, but the same checks are useful when comparing a commercial tender.
Use the requirements issued with the tender where a formal procurement process applies.
Lastly, clarify the tender before appointing a builder
Do not appoint a builder while material qualifications are sitting in an email chain. Bring the accepted scope, adjustments, allowances, exclusions, schedule and tender clarifications into the final contract package.
Contract terms and risk allocation vary by project. Coverite's guide to construction projects and building contract types provides general context, but project-specific commercial and legal advice is still required.
Coverite can help check scope and delivery risk before appointment. Speak with our team about the proposed works.
